Thank you for visiting the blog. It is dedicated to the 2025 storm restoration project. Please refer to the map for reference as to when your area of the community will be worked on. Please visit the blog periodically for project information, answers to frequently asked questions, and project status updates. We appreciate your patience during the project.
Project links “Click to view”
RCA- Shingle Replacement Notice
landmark-series-brochure-00-00-133-NA-EN-2302-nc-v2
On-site Project Manager Henry Hernandez
Cell: 612-638-8700
Shingle color selected by the Board
“CertainTeed Landmark”
Weathered Wood
Equipment to be used during the project
All dates and proposed plans are “Weather Permitting” and subject to change with little notice

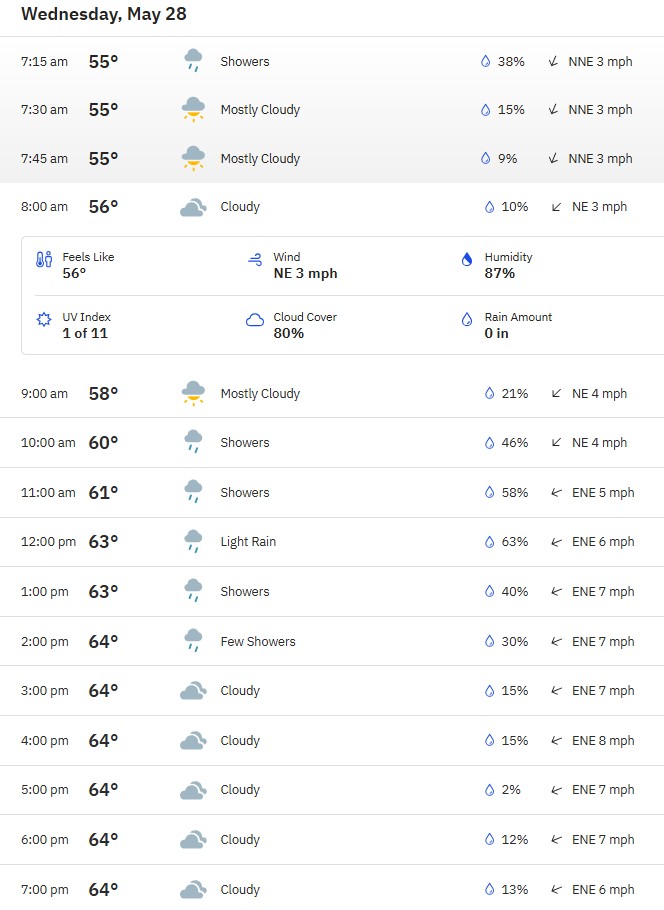

5/28/2025- More rain is forecasted for today, so no work will take place today. The crew will complete building 4 tomorrow, weather permitting.

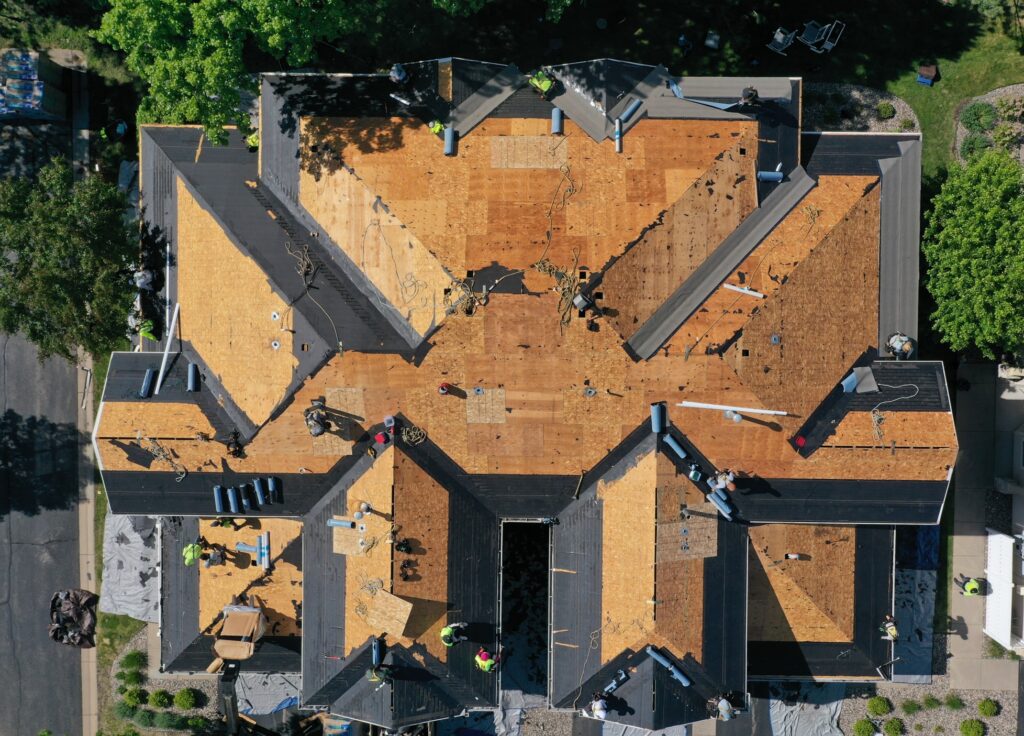

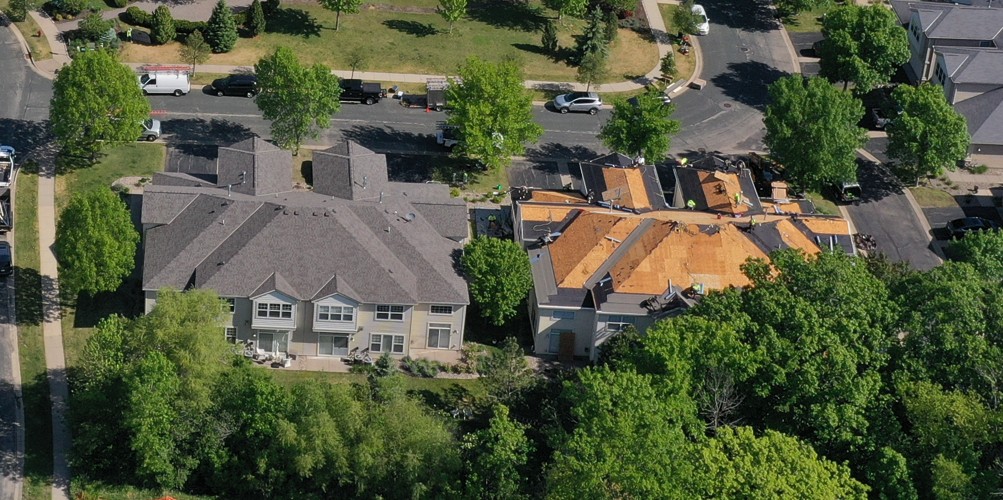

5/27/2025- On Friday, the crew completed building 2. Today, they are working on building 3 (14531, 14533, 14535, and 14537 Quebec Ave).
There’s a slight chance of rain tomorrow. We’ll watch the forecast and determine if building 4 (14521, 14523, 14525, and 14527 Quebec Ave) can start tomorrow. If you live in building 4, please plan on work starting tomorrow.

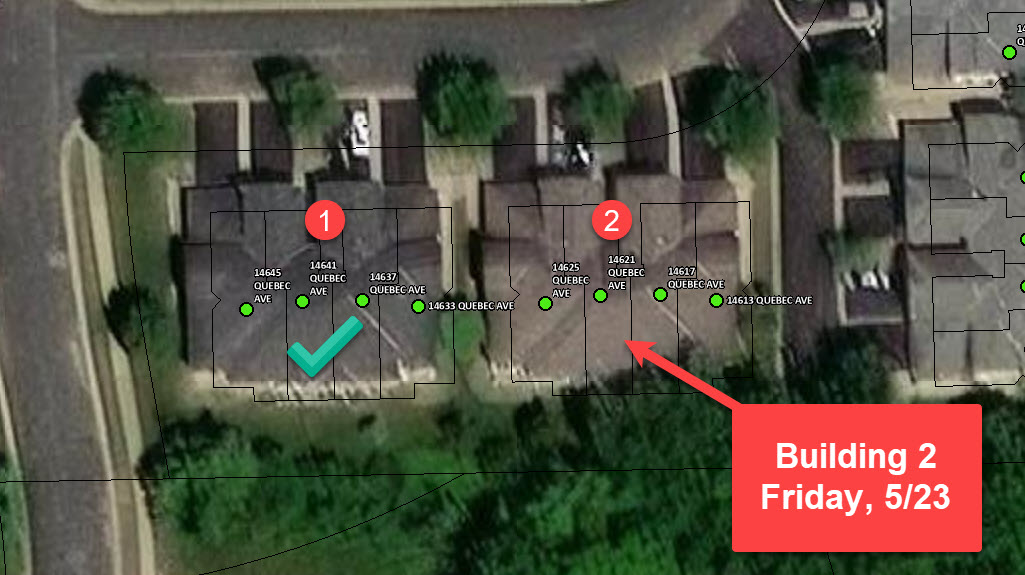

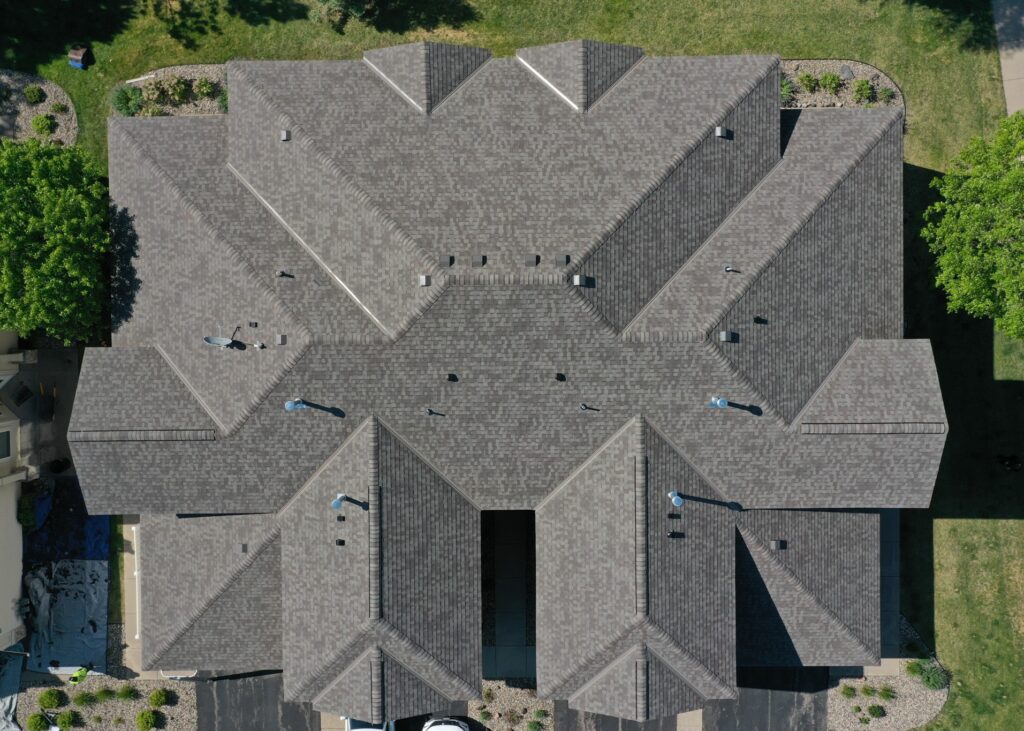

5/22/2025- After three straight rain days, today was perfect for roofing. It’s going to be a long day, but the crew will finish building one. They will move to building 2 (14613, 14627, 14621, and 14625 Quebec Ave) tomorrow, Friday, May 23rd. If you live in this building, please make sure you have your vehicles out of your garage and off the driveway by no later than 7:00 AM.
We will allow everyone to enjoy the long Memorial Day weekend and return on Tuesday, May 27th.

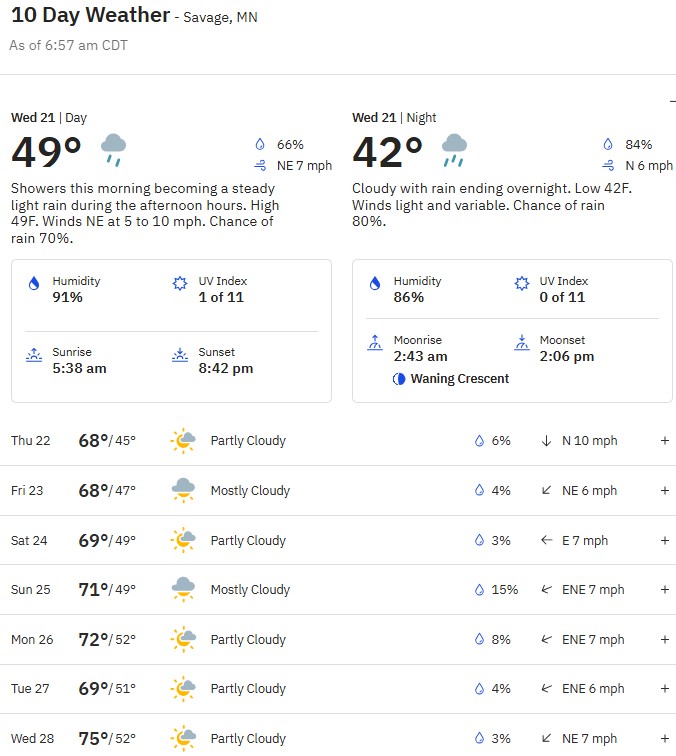

5/21/2025- The project started off soggy! We haven’t been able to complete any work this week, and today is no different. It’s currently wet out now with a chance of more rain later today. Fortunately, we have a very nice stretch of weather on the way. Tomorrow will be the first chance to complete some work. The crew will work on building 1 (14633, 14637, 14641, and 14645 Quebec Ave) tomorrow and 2 on Friday. No work will be completed over the Holiday Weekend.
5/19/2025- Unfortunately, the weather forecast showed a great enough chance for rain this afternoon that we decided not to start any roofing today. The chance of rain persists tomorrow (complete washout), and Wednesday has a 30% or greater chance for the day. We’ll have to watch the forecast and determine if work can start on Wednesday, or will the start of the project be Thursday, May 22nd?? The beginning of the week is unstable.

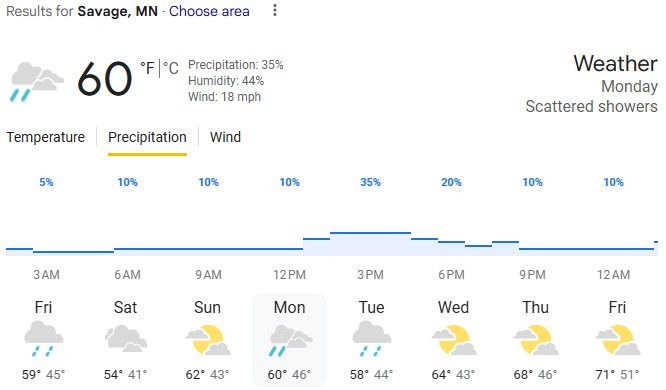

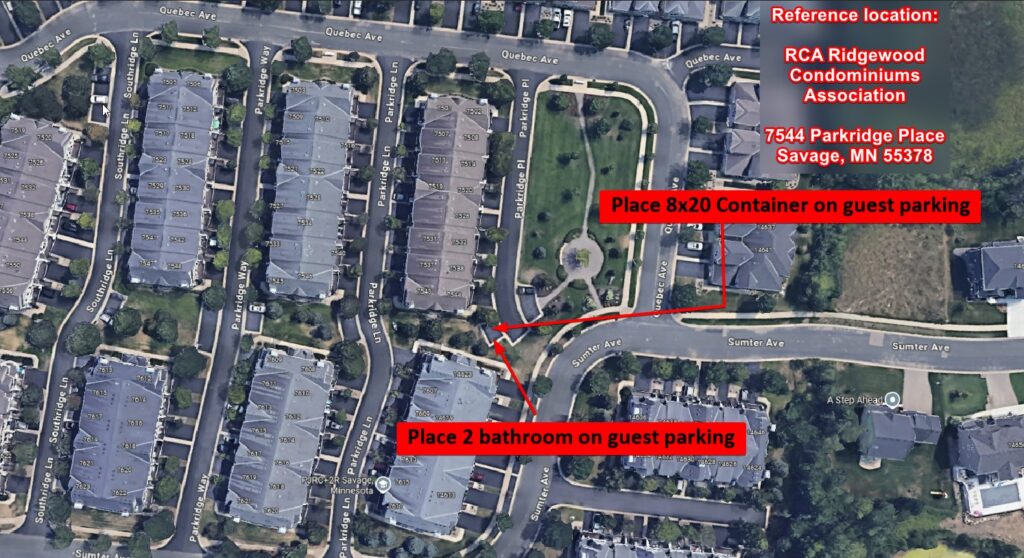

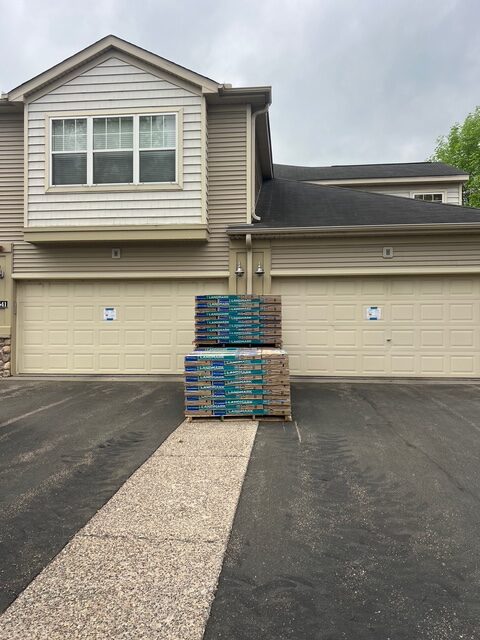

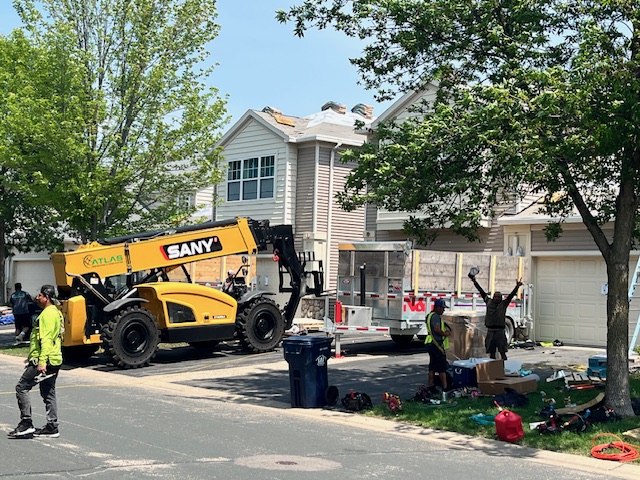

5/16/2025- As you may have seen, the material, equipment, storage container, and on-site restrooms have been delivered and staged throughout the community. On Monday, May 19th, the roof replacement of building 1 (14633, 14637, 14641, and 14645 Quebec Ave) will begin. Notices have been posted on the garage doors as a reminder.
As of now, there is a slight chance of rain on Monday. We will continue to monitor the forecast and will make a call Monday morning if work will be delayed.
